Project Details

US 20/CAZENOVIA CREEK

Project ID No. 511177 , Contract Number D265151

Description

This project replaces the US Route 20 bridge over Cazenovia Creek (BIN 1015520) in the Towns of Elma and West Seneca, Erie County. Work includes bridge widening to accommodate 5 lanes and includes highway widening from 3 to 5 lanes north of the bridge to Seneca Street and south of the bridge to NY Route 187, Transit Road.

Project Overview

Project Status

  • The project has been Under Construction.
  • The Bid Opening was on 12/14/2023

Project Schedule

Award of Contract Original Contract Completion Date* Estimated Substantial Completion Date* Construction Schedule Variance from Contract Award**
02/15/2024 12/31/2026 12/01/2026 Schedule Variance Indicator

**Schedule Variance Key:
● Red - Current Schedule Variance is > 10% of Original Completion
● Yellow - Current Schedule Variance is > 5% and <=10% of Original Completion
● Green - Current Schedule Variance is within 5% of Original Completion

Construction Costs

Contract Award Cost Approved Cost Changes Current Construction Contract Cost Cost Variance of Construction Contract**
$48,450,047 $753,335 $49,203,382 Cost Variance Indicator

**Cost Variance Key:
● Red - Current Construction Costs are > 10% of Contract Award Cost
● Yellow - Current Construction Costs > 5% and <=10% of Contract Award Cost
● Green - Current Construction Costs are within 5% of Contract Award Cost

This project receives funding from the following sources:

Federal: Yes

State: Yes

Local: Yes

*Project Schedule Definitions:
Original Contract Completion Date - This is a contractual date,at the time the Contractor is Awarded the contract, representing when the Contractor is obligated to complete all of the work required in the contract and will no longer have a presence within the highway Right-of-Way.

Estimated Substantial Completion Date - This is the day the public (including vehicles and pedestrians) has full and unrestricted use and benefit of the facilities both from the operational and safety standpoint.

Location

This project is located in the WESTERN NEW YORK region and includes the following:

Counties
ERIE

Towns
ELMA
WEST SENECA

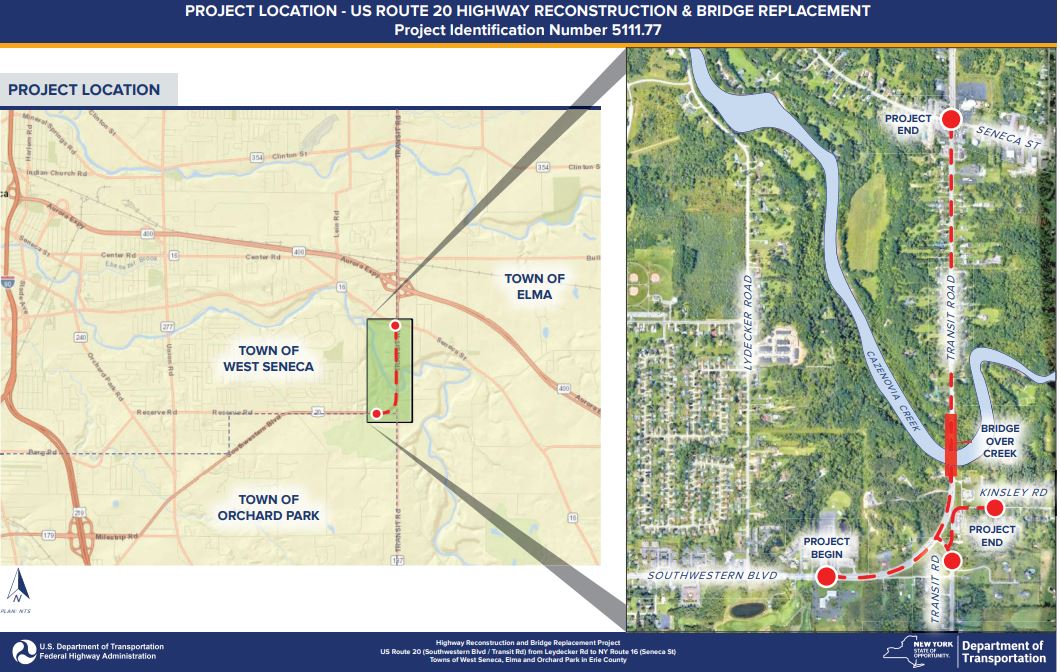

05 Region Map

Legislative District:

This project falls within the geographical boundaries of the following legislative districts:

U.S. Senators
Schumer, Charles E.
Gillibrand, Kirsten

U.S. Congressional District(s)
23th Congressional District (Nicholas Langworthy)

State Senatorial District(s)
60th Senatorial District (Patrick M. Gallivan)

State Assembly District(s)
142th Assembly District (Patrick Burke)

Statewide Transportation Improvement Program (STIP)

The Statewide Transportation Improvement Program (STIP) is a list of every project in New York State for which Federal funding is proposed to be used and that is scheduled to begin during the designated three Federal fiscal year time frame. To review the STIP Project List by Region please see the STIP Project Report.

History

About this project:

The proposed project is intended to address the existing structural deficiencies of the US Route 20 (Transit Road) bridge over Cazenovia Creek and address existing roadway deficiencies, improve pedestrian and bicyclist accommodations, and reduce traffic delays on US Route 20 (Transit Road) between Leydecker Road and NY Route 16 (Seneca Street).



Public Involvement:

A Public Hearing will be held on Thursday, July 21, 2022, between 4:00 pm and 6:30 pm at West Seneca Community Center and Library which is located at 1300 Union Road, West Seneca, New York. There will be an open house from 4:00 pm to 5:00 pm followed by a formal presentation at 5:00 pm.

This project is located in the Niagara Frontier region and includes the following:

Counties: Erie

The project limits for this project extends just west of Reserve Road to just south of NY Route 16 (Seneca Street) along US Route 20 (Transit Road) within the Towns of West Seneca, Elma, and Orchard Park in Erie County.

Community Outreach

NOTICE OF

PUBLIC HEARING AND NOTICE OF AVAILABILITY

OF DRAFT DESIGN APPROVAL DOCUMENT

NEW YORK STATE DEPARTMENT OF TRANSPORTATION

P.I.N. 5111.77



In accordance with the provisions of Title 23, U.S. Code, Section 128 and Title 40, Code of Federal Regulations, Parts 1500 to 1508; the New York State Department of Transportation (NYSDOT) will hold a Design Public Hearing for the proposed bridge replacement and highway reconstruction project for US Route 20 (Transit Road) from west of Reserve Road to south of NY Route 16 (Seneca Street) in the Towns of West Seneca, Elma, and Orchard Park, Erie County.

The hearing will be held in an open forum format at the following time and location:



Thursday, July 21, 2022

4:00 PM to 6:30 PM

Town of West Seneca

1300 Union Road,

West Seneca, NY 14224



The open forum hearing will consist of an information session from 4:00 pm to 5:00 pm. and a formal meeting beginning at 5:00 pm.

There will be displays and informational stations staffed with NYSDOT representatives familiar with the various aspects of the proposed project. NYSDOT representatives will also be available to answer residents’ questions and provide information about the project.

Further information on the project may be obtained from and any written comments sent to:

Ms. Sanjyot Vaidya, P.E., Regional Design Engineer

New York State Department of Transportation

100 Seneca Street, Buffalo, NY 14203

If a sign language interpreter is needed, or there are any other special needs, please call 716-847-3214 by July 14, 2022

Reports/Documents

Additional Info/Links

About this project:

The proposed project is intended to address the existing structural deficiencies of the US Route 20 (Transit Road) bridge over Cazenovia Creek and address existing roadway deficiencies, improve pedestrian and bicyclist accommodations, and reduce traffic delays on US Route 20 (Transit Road) between Leydecker Road and NY Route 16 (Seneca Street).



Public Involvement:

A Public Hearing will be held on Thursday, July 21, 2022, between 4:00 pm and 6:30 pm at West Seneca Community Center and Library which is located at 1300 Union Road, West Seneca, New York. There will be an open house from 4:00 pm to 5:00 pm followed by a formal presentation at 5:00 pm.

Objectives

  • Provide a safe, durable, and adequate structure over a design life of greater than 75 years using cost effective techniques to minimize the life cycle cost of maintenance and repair with minimal impacts to the traveling public during construction
  • Correct identified pavement deficiencies, i.e., pavement heaving in shoulders, that will extend the useful life of the highway and maintain it in a structurally sound condition using cost effective pavement treatments which provide low life cycle costs.
  • Increase capacity for forecast ETC+20 design year traffic and improve Level of Service with minimal environmental and right of way impacts.
  • Enhance pedestrian and bicyclist accommodations within the project limits.

Alternatives

Alternatives Under Consideration:



Alternative 1: Maintenance or No Build “Null” Alternative



Under this alternative, no improvements would be made and routine preventive maintenance, as well as corrective action within the capabilities of Regional Maintenance forces, would be undertaken. The Null/Maintenance alternative will result in the continued deterioration of the structure and roadway, resulting in further traffic delays, restrictive load postings, continued safety concerns, and eventual closure of the structure. This alternative is being retained for comparison with the preferred build alternative but does not meet the project objectives.



Preferred Alternative 2: Bridge Replacement and Highway Reconstruction



This alternative would completely replace the existing structure with a continuous span, steel multi-girder superstructure with a composite reinforced concrete deck. The total length of the bridge would be approximately 850 feet on conventional cantilever abutments and concrete piers founded on spread footings on rock. This alternative would also include highway reconstruction north of the structure to the Seneca Street intersection and south of the structure to Reserve Road. The full-depth reconstruction north of the bridge would widen the existing corridor to carry two 12’ travel lanes in each direction, a 12’ continuous Two-Way Left Center turn lane, 5’ shoulders, 5’ sidewalks, and a closed drainage system would be provided on both sides of the highway. This section would include the replacement of an 18” unlabeled culvert to current standards at RM 20 5302 1281 and CIN 544017450. The full depth highway reconstruction south of the bridge is required to tie the existing alignment into the shifted alignment for the new structure (alignment is widened to the east). The realigned section south of the bridge would consist of two 11’ travel lanes in each direction, a 12’ continuous Two-Way Left Center turn lane, 8’ shoulders, and an open drainage system. This shift in alignment would introduce a reverse curve on US Route 20 north of the structure to tie into the existing alignment. Culverts CIN 544017013, CIN 544016857, CIN 544017197, and CIN 544021131 are all within the limits of this section of reconstruction and will be reconstructed to be within current standards. Realigning US Route 20 will require modifying the curve on Kinsley Road to accommodate the larger horizontal curve of US Route 20. This realignment on Kinsley Road would require reconstructing the curve near the existing RV dealer to bring it further away from the existing concrete barrier. More information regarding the realignment of Kinsley Road can be found below. This alternative will accommodate a wider typical section to provide adequate traffic capacity, as well as separate pedestrian facilities and bicycle accommodations on the shoulders. See Appendix A for typical sections. Various work zone traffic control options were considered for this alternative, refer to Section 2.7.2 for discussion on the options that were considered. The preliminary construction cost estimate for this alternative is approximately $39.5M. This alternative would constitute an “Adverse Effect” on the existing eligible historic structure. This alternative meets the project purpose and objectives and is the preferred alternative.



Alternatives Found to be Not Reasonable:



Alternative 3: Bridge Replacement on New Horizontal Alignment and Highway Reconstruction



This alternative would include complete removal of the existing structure and construction of a new bridge on a new horizontal alignment to the east of the existing structure. This alternative would also include highway reconstruction north of the structure to the Seneca Street intersection and south of the structure to Reserve Road. The full-depth reconstruction north of the bridge would widen the existing corridor to carry two 12’ travel lanes in each direction, a 12’ continuous Two-Way Left Center turn lane, 5’ shoulders, 5’ sidewalks, and a closed drainage system would be provided on both sides of the highway. This section would also include the replacement of an 18” unlabeled culvert to current standards at RM 20 5302 1281 and CIN 544017450. The full depth highway reconstruction south of the bridge is required to tie the existing alignment into the proposed alignment for the new structure. The realigned section south of the bridge would consist of two 11’ travel lanes in each direction, a 12’ continuous Two-Way Left Center turn lane, 8’ shoulders, and an open drainage system. Culverts CIN 544017013, CIN 544016857, CIN 544017197, and CIN 544021131 are all within the limits of this section of reconstruction and will be reconstructed to be within current standards. This realignment will require constructing a new roadway to connect Kinsley Road to Old Transit Road (NY Route 187). This shift in alignment would also introduce a reverse curve north of the structure to tie into the existing alignment. This alternative will accommodate a wider typical section to provide adequate traffic capacity and would eliminate the need for an offsite detour. This alternative would also provide separate pedestrian facilities and bicycle accommodations on the shoulders. To realign US Route 20, a significant amount of additional right of way acquisitions would be acquired and relocation of seven properties would be required (five residential and two commercial). Additionally, this alternative will have more environmental impacts compared to the preferred alternative, as more previously undisturbed land will be required to realign US Route 20. The preliminary construction cost for this alternative would be approximately $41.9M. This alternative provides the same transportation improvements as alternative 2 at an additional cost of $2.4M, additional environmental impacts, and requires substantially more right-of-way acquisitions. Compared to alternative 2, this alternative requires an additional 2.8 acres in FEE acquisitions, five private property relocations, and two commercial property relocations. This alternative would constitute an “Adverse Effect” on the existing eligible historic structure.



Alternative 4: Bridge Rehabilitation – Deck Replacement



This alternative would include the replacement of the existing deck, overhangs, and traffic barrier. It would also include concrete repairs to the existing arches, spandrel columns, and floorbeams, as well as the replacement of select spandrel columns and floorbeams that exhibit severe deterioration. Continued maintenance would be required on the superstructure and substructure due to continuing deterioration. It is anticipated that the service life of the rehabilitation would be 25 years, at which point the structure would be 120 years old and would need to be replaced. Rehabilitation would not be able to facilitate five lanes of traffic which is required to increase the Level of Service of the highway corridor and maintain the existing center turn lane for the safety of the nearby residences adjacent to the existing structure.

Rehabilitation would also not be able to provide sidewalks, an important aspect of a complete street, and pedestrian traffic would have to be accommodated on the shoulders. Due to the nonredundant nature of the existing structure, staged construction is not feasible and the bridge would need to be closed during construction. This would require an 8.5-mile off-site detour. A traffic analysis of this off-site detour was completed and it showed a poor level of service along the detour without performing significant upgrades to the detour route. These upgrades would require a significant amount of additional right-of-way acquisitions, utility relocations, and environmental impacts. Due to these additional delays, the length of the detour, and the large amount of traffic that the existing structure carries, the residual costs on the traveling public are high. The preliminary construction cost estimate for this alternative is approximately $13.6M. This alternative is expected to constitute a “No Adverse Effect” on the existing eligible historic structure. This alternative was dismissed because it does not meet the project purpose and objectives.

For a more in-depth discussion of the design criteria and nonstandard features for the reasonable alternative(s) under consideration see Section 2.5 of this report.





Kinsley Road Realignment Options

As a result of the preferred alternative, Kinsley Road will need to be realigned. The current road turns sharply around an existing RV retail and repair business coming within close proximity to both Transit/Southwestern Blvd. and the above-mentioned business. The lack of superelevation along Kinsley Road at this location has contributed to a history of roll-over accidents with trucks prompting the installation of barrier between Transit Road and Kinsley Road. The following two options were considered:



Option Under Consideration:

Altered Alignment Option: This realignment for Kinsley maintains a large portion of the existing alignment and would only alter the curved section affected by the shifting of US Route 20. The existing curve would be replaced with two curves and a small tangent section. This design will provide standard pavement and shoulder widths. There will be no physical separation between the realigned roadway and adjacent businesses with the pavement edge 11’ from the edge of the highway boundary and the building corner 9’ away, there will be no impact upon the businesses. All adjustments to the roadway can be accomplished within the existing highway boundary and would result in no easement/property acquisitions and minimal environmental disturbance. A stop condition was investigated for the curve on Kinsley Rd. and was deemed that the situation did not warrant a stop condition and could not be utilized, based on coordination with Regional Traffic and Safety. A connection to US Route 20 was also investigated, however due to the connection being severed in the past due to safety concerns and the proximity to the existing signal at Old Transit, Regional Traffic and Safety deemed this situation to be unacceptable.



Option Found to Be Not Reasonable:

New Alignment Option: This alignment for Kinsley creates a new alignment running through the wooded area to the east of the current alignment. There would be a stop condition at the intersection to the current Kinsley Rd. as well as its southern intersection. Kinsley Rd. would need to be dead ended with possible cul-de-sacs on either side of the current curve. These dead ends would need to still be maintained by the town as they both service businesses. There is significant ROW that would need to be acquired to construct this alignment. There would also be significantly greater construction costs due to the scope of this new alignment.

The Altered Alignment Option is the preferred option due to minimal costs, environmental disturbance, and property acquisitions. This option meets current roadway standards.

Schedule

Activity                                       Date Occurred/Tentative

Scope/Design Approval                        Summer 2022

Bid Opening                                             Fall 2023

Contract Award                                        Fall 2023

Construction Start                                   Fall 2023

  Construction Complete                        December 2025

Photos/Visualizations

Construction Information

This section will be updated once the project has been awarded.

Traffic Control Plan

Three work zone traffic control options were evaluated for the preferred alternative.



Preferred Option:

Staged Construction: Under the preferred option, traffic will be carried on the existing structure and the west side of the existing roadway while the first stage of the proposed bridge and highway reconstruction is completed to the east. Traffic will then be shifted to the completed portion of the new bridge and highway while the existing bridge is demolished, and the remainder of the proposed bridge and highway is constructed. Bicycles and pedestrians will utilize the shoulder of the existing bridge during the first construction stage and the shoulder of the new structure during stage 2 of construction. The intersection at US Route 20 and Old Transit Rd. will utilize a temporary signal during construction and the current signal will be reconstructed. Emergency Services and Schools will be coordinated with prior to and during construction to ensure services are continuous. Refer to Appendix A for staged construction sections.



Options Found to Be Not Reasonable:

Off-Site Detour: The off-site detour would consist of an 8.5-mile detour along NY Route 16, NY Route 277, and NY Route 240. A traffic analysis of this off-site detour was completed and it showed a poor level of service along the detour. In order to increase this level of service, significant upgrades to the detour route would be required which would include a significant amount of additional right-of-way acquisitions, utility relocations, and environmental impacts. Due to the additional delays traffic delays, the length of the detour, and the large amount of traffic that the existing structure carries, the residual costs on the traveling public are high and this option was deemed to be not reasonable.



Temporary Bridge: This option would involve constructing a two-lane temporary bridge with approaches located to the east of the existing structure while traffic is maintained on the existing bridge. Once the temporary bridge is in place, traffic would be diverted via the temporary approaches to the temporary bridge. Once the existing structure is demolished, the western portion of the proposed bridge and highway reconstruction would be constructed. Traffic would then be diverted to the newly constructed structure and highway section while the temporary bridge is removed and the remaining eastern portion of the structure and highway is completed. The estimated cost for the temporary bridge and approach work is $5.5M. Due to this large additional cost, this option was found to be not reasonable.



The work zone traffic control will need to be coordinated with local officials, residents, emergency responders, and school districts. No additional environmental impacts will occur.

Contact Us:

If you have questions about this project, please contact us:

Ryan Whalen
100 Seneca Street
Buffalo, NY 14203
Phone: 716-847-3239
Email: ryan.whalen@dot.ny.gov
Provide feedback on this project
